Please note the map above is only a representation and not an exact location of our construction route.
Progress Updates:
April 2, 2026:

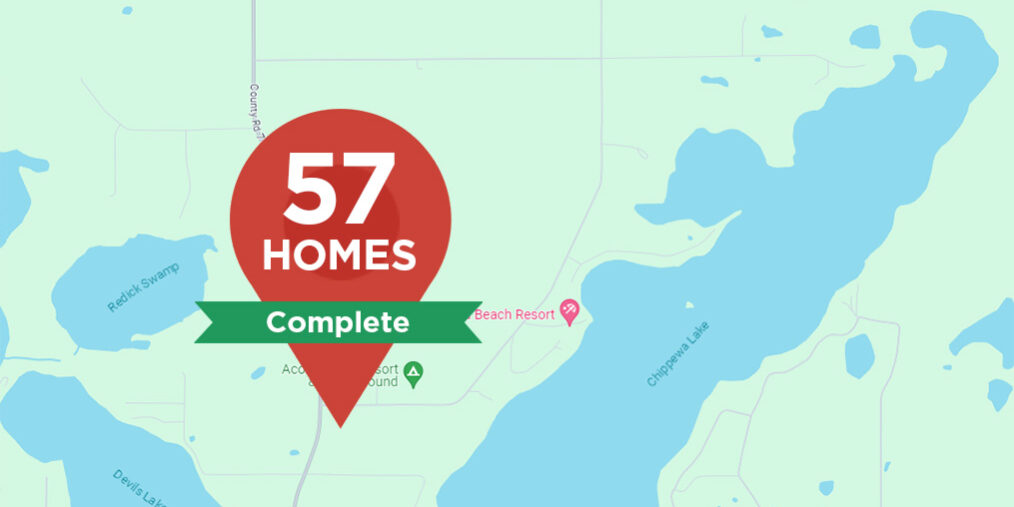

The Strom Drive project is complete! All homes or businesses have been installed with fiber-optic service.
November 5, 2025:
Construction is almost complete for Strom Drive Fiber Project! Once construction is complete, we will start splicing.
October 17, 2025:

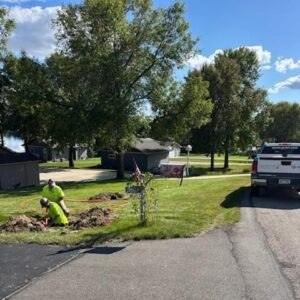

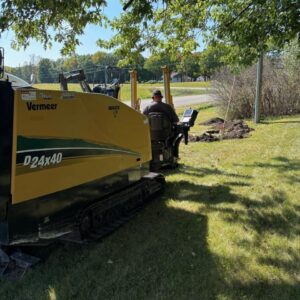

Construction is about 50% complete on the Strom Drive Phase 1 Fiber Project! If you haven’t scheduled your fiber optic site visit yet, please give us a call at (320) 834-7253 as soon as possible.
September 23, 2025:
Construction has started for the Strom Drive Phase 1 Fiber Project! If you haven’t scheduled your fiber optic site visit yet, please give us a call at (320) 834-7253 as soon as possible!
![]() |
![]() |
September 17, 2025:
Locates have been called in for the Strom Drive Phase 1 Fiber Project. Once all of the underground facilities have been marked, construction will begin! If you haven’t scheduled your fiber optic site visit yet, please give us a call at (320) 834-7253 as soon as possible!
March 26, 2025:
The Strom Drive Fiber Project is in the hopper for 2025 construction! We will be passing 57 co-op members’ homes or businesses in the Strom Drive area with fiber-optic cable. We’re doing our best to get fiber-optics delivered to your neighborhood as quickly as possible. While you wait, we get busy! We’re planning construction areas, working with local authorities for permits, engineering your network and lots of other behind the scenes work. Learn about what to expect here.
This includes some locations along:
- Chippewa Heights NW
- County Road 7 NW
- Strom Drive NW
