Project Phase:

Progress Updates:
February 5, 2024:

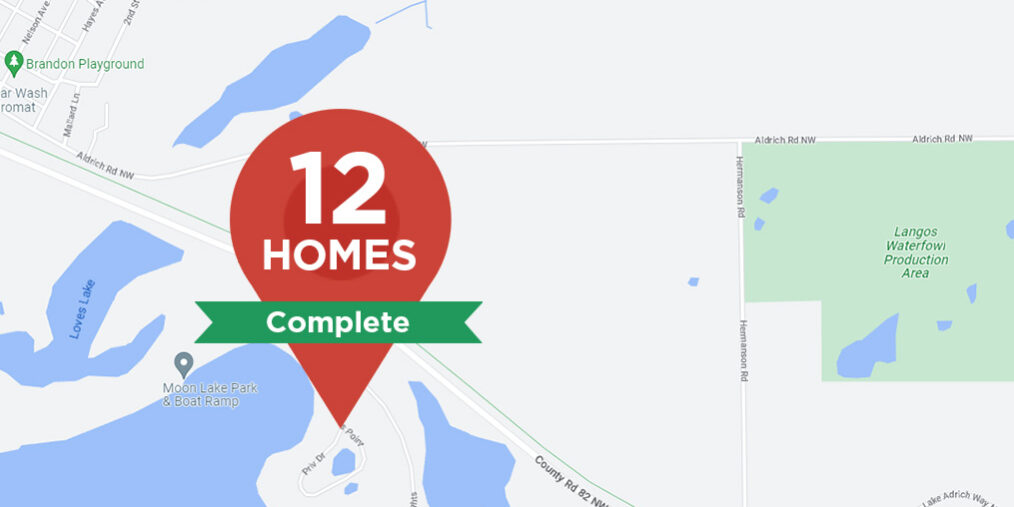

The Aldrich Road fiber project is complete! All homes or businesses have been installed with fiber-optic service.
October 24, 2023:
We have completed the splicing for the Aldrich Road fiber project. We are scheduling installations for this project. Call / text us at (320) 834-7253 to schedule your fiber optic installation!
August 8, 2023:
We are working on splicing the Aldrich Road fiber project.
June 13, 2023:
We have completed the mainline and fiber drops for the Aldrich Road fiber project. The next step will be splicing.
February 14, 2023:
The Aldrich Road Project is in the hopper for 2023 construction! We will be passing 12 co-op members’ homes or businesses in the Aldrich Road area with fiber-optic cable. We’re doing our best to get fiber-optics delivered to your neighborhood as quickly as possible. While you wait, we get busy! We’re planning construction areas, working with local authorities for permits, engineering your network and lots of other behind the scenes work. Learn about what to expect here.
This includes some locations along:
- Aldrich Rd NW
- Front St E
- Mallard Ln
